City Rail Link

Maungawhau Station East notifications archive

Maungawhau Station East notifications archive


SURROUNDING STREETS : Boston Road, Severn Road, Auburn Street, Nugent Street, Lauder Road, Normanby Road.

This page is an archive for all Maungawhau Station East notifications prior to 5/11/21.


Previous notifications

Road changes

TIPS FOR READING THE PDFS BELOW

  • To read this full screen, press on the square symbol at the bottom right of the box.

  • The document then opens in a new tab. Press the escape key to return to this page.

  • To download, when you view full screen, depending on your browser, there is an arrow at the top left of the screen - click on that.

<


Normanby Road Temporary Level Crossing Closure


Boston Road - manhole strengthening

A manhole located in Boston Road near JA Russell, needs to be strengthened with concrete. This will mean the reduction of traffic to a single lane to enable sufficient space for our work site.

This work will take place on Saturday 28 August.

This work will include:

  • Traffic Management to divert vehicles as required

  • Removing the asphalt

  • Hydro-vacing to expose the manhole connection. This will be noisy.

  • Mixing and pouring the concrete

  • Reinstatement of the road surface

  • The hours of work will be between 7am and 7pm.

The equipment required will include:

  • Excavators and hydrovac

  • Hand tools

  • Hot mix asphalt for the reinstatement of the road surface

Traffic controllers will be onsite to assist with traffic movement and noise reduction mats to mitigate noise disturbance.

Normanby Road - bridge end

As part of the works to widen the rail corridor for the City Rail Link, utilities are required to be relocated. This work is ongoing and undertaken as required.

During the week commencing 30 August, we will be cutting and removing asphalt using an excavator and hydrovac, to gain access to the existing ducts within the road. This will require the car parks on both sides of the road to be removed to enable sufficient working space while maintaining traffic movement. This work is expected to only take one day and be intermittently noisy. Noise reduction mats will help mitigate noise disturbance.

Night work - Normanby Road Bridge

From Monday 30 August to Sunday 5 September, we will be placing bridge beams.

A portion of this work will be carried out on night shifts between the hours of 10pm and 5am.

The work will involve the placement of 16 bridge beams early September. There will be truck and crane movements into site, potentially causing disruption to motorists travelling on Boston/Nugent Road – traffic controllers will be on site to help mitigate this. Light towers will be used to help illuminate the site with potential for light pollution – all lights will be facing towards site to help minimize this.

The required equipment will include cranes, truck, light towers and power tools.


Weekend of 21, 22 August

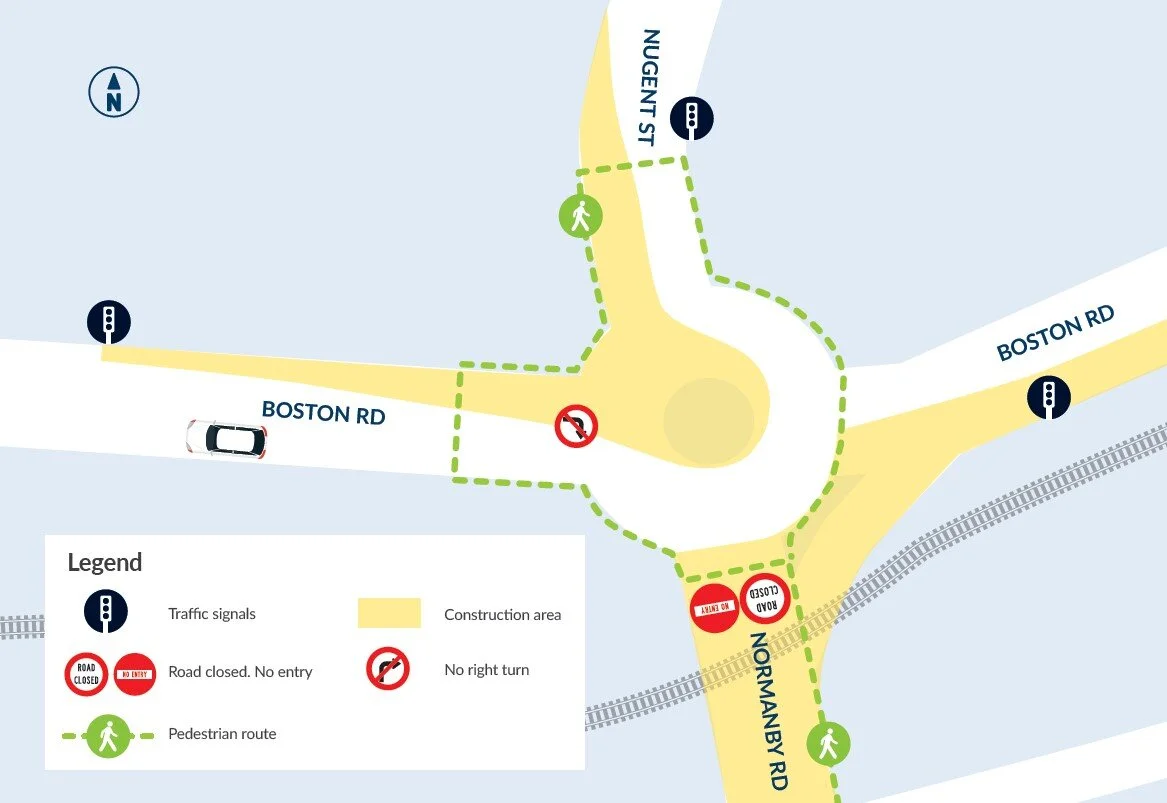

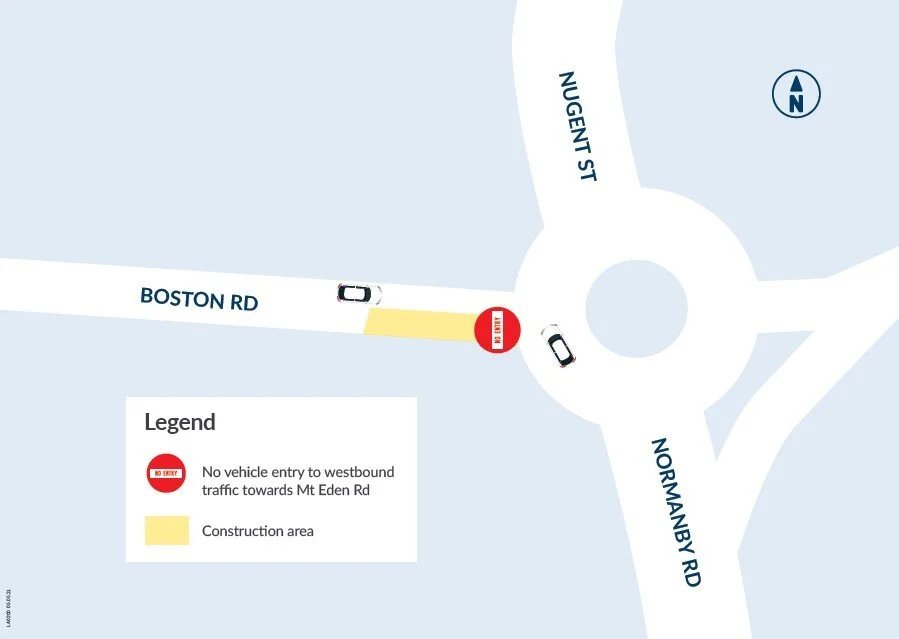

As part of the ongoing work to build the additional CRL line, we will be working on a variety of activities in the rail corridor over the weekend of 21, 22 August during Block of Line, when the trains are not running.

All this work will be undertaken between 7am to 7pm on Saturday 21st and 8am to 7pm on Sunday 22nd.

Where: In the rail corridor - east of the station (zones 1 and 2)

Scope of work:

  • Installing ducting and pits

  • Relocation of hoarding and removal of a light pole

  • Hoarding Removal and installation of precast panels

Equipment: Digger, excavator, hand tools, rock breaker, compactor, roller.

What to expect: This work will involve excavation of the current rail system for the installation of under-track services and relocation of removal of hoardings to make way for the works to proceed. Where possible, noise mats will be used to mitigate noise disruption.


Update 1 August 2021

We are continuing to undertake extensive excavation, service upgrades and foundation work, in preparation for the future City Rail Link tunnels and re-developed Mt Eden Station. Over the coming weeks, the following activities will commence in zones 1 and 2:

• Normanby Road: Install a network of upgraded services and storm water drainage

• Piling across the rail corridor

• Line marking on Mt Eden Road

• Eastern Grade Separation

Normanby Road - Install a network of upgraded services and storm water drainage

The team continue to excavate on Normanby Road, between the Boston Road roundabout and Enfield Street. This work is required to isolate existing services within the road and to install a network of upgraded services and storm water drainage.

The work will take approximately six months to complete and will require the temporary removal of carparks on Normanby Road (see map below). The temporary removal of parking spaces ensures that traffic in both directions and access to properties will be maintained.

This work will include:

• Traffic Management to divert pedestrians and vehicles when required

• Excavation and drilling under the road

• Installation of trench shields

• Pulling ducting and services across the road

• Installation of drainage services under the road

• Reinstatement of the road surface

• The hours of work will be between 7am and 7pm, Monday to Saturday

The equipment required will include:

• Concrete trucks and concrete pumps

• Cranes

• Excavators

• Hand tools

• Hot mix asphalt for the reinstatement of the road surface

• Noise mats to mitigate noise nuisance

• Lighting

Piling across the rail corridor

As part of the works to widen the rail corridor for the new City Rail Link lines, a series of foundation works are taking place with within our construction site.

The team continue to drill bored piles along the rail corridor, on the Eastern side of Mt Eden. The main impact from these works is noise from the piles being drilled into the ground. Attended monitoring will be performed to ensure we comply with the consented conditions.

Line marking on Mt Eden Road
On the 28th of July to the 29th of July, the team will begin line marking maintenance on Mt Eden Road, between the intersections of Enfield Street and Boston Road.

This work will be carried out on night shifts between the hours of 10pm and 5am. During these works, there will be traffic management in place and traffic lane closures will be implemented when required.

Eastern Grade Separation on the rail corridor

The Eastern Grade Separation (EGS) is a series of complex works to accommodate the additional City Rail Link Northbound Line. Grade separation is a method of aligning the junction between two rail lines, which cross each other at different heights. A transitional trench from the East will dive below the Normanby Road over-rail bridge, in a northerly direction. The rail line will then enter the tunnel located at the Mt Eden station site, and travel towards Karangahape Road. The existing rail line will remain at ground level, travelling towards Kingsland. As part of the EGS works, a series of foundation works will take place within our construction site to support the structure.

The stage of work has started and will continue until early October 2021.

This work include:

• Tying and reinforcing steelwork

• Concrete pours for the foundations and roof slab

• Concrete breaking

• Erecting formwork

• The hours of work will be between 7am to 10pm, Monday to Saturday

The key equipment will include:

• Concrete trucks

• Excavators

• Crane

• Hand tools

• Noise mats to mitigate noise nuisance

• Lighting


Update 01 July 2021

We are continuing to undertake extensive excavation, service upgrades and foundation work, in preparation for the future City Rail Link tunnels and re-developed Mt Eden Station. Over the coming weeks, the following activities will commence in zones 1 and 2:

• Normanby Road over-rail bridge construction

- Temporary Services Bridge

- Enfield Street footpath improvement

- Roundabout and Boston Road island removal

• Normanby Road: Install a network of upgraded services and storm water drainage

• Boston Road temporary closure

• Piling across the rail corridor

• Eastern Grade Separation

Normanby Road over rail bridge construction - Update

As part of the works to construct the new Normanby Road over-rail bridge, a series of preparation works are commencing on the East side of Mt Eden.

Temporary Services Bridge

Enfield Street footpath improvement

In preparation for when the Normanby Road level crossing is closed to pedestrians, and when people on foot are diverted over the new Temporary Services Bridge, Link Alliance are undertaking footpath improvement works on Enfield Street. This is to improve accessibility and to provide a suitable alternative route for those using a walking aid, pram, bike or scooter. The upgrade work includes installing tactiles on Enfield Street and restoring sections of the footpath surface.

Roundabout and Boston Road island removal

On Saturday the 3rd of July the team will begin to remove the roundabout at Boston Road and replace it with a temporary structure. This is part of wider works to construct the Normanby Road over-rail bridge and to redevelop the surrounding roads.

The removal will be carried out over full the weekend in the day as well as during night works, and will be complete by 5am on Monday the 5th of July. Traffic Management will be in place for the duration of the works and access to businesses will be maintained at all times.

Normanby Road - Install a network of upgraded services and storm water drainage

On Monday the 12th of July, the team will begin excavation on Normanby Road, between the Boston Road roundabout and Enfield Street. This work is required to isolate existing services within the road and to install a network of upgraded services and storm water drainage.

The work will take approximately six months to complete and will require the temporary removal of carparks on Normanby Road (see map below). The temporary removal of parking spaces ensures that traffic in both directions and access to properties will be maintained.

This work will include:

• Traffic Management to divert pedestrians and vehicles when required

• Excavation and drilling under the road

• Installation of trench shields

• Pulling ducting and services across the road

• Installation of drainage services under the road

• Reinstatement of the road surface

• The hours of work will be between 7am and 7pm, Monday to Saturday

The equipment required will include:

• Concrete trucks and concrete pumps

• Cranes

• Excavators

• Hand tools

• Hot mix asphalt for the reinstatement of the road surface

• Noise mats to mitigate noise nuisance

• Lighting

Boston Road temporary closure - Update

On Friday the 9th of July the team will continue to excavate the road outside 49 Boston Road. This work is required to isolate existing services within the road and connect the new wastewater services (see map below).

This work will take place over two weekends:

• 9th-12th of July

9pm on Friday the 9th of July until to 5am on Monday the 12th of July

• 16th-19th of July

9pm on Friday the 16th of July until to 5am on Monday the 19th of July

This work will include:

• Traffic management in place

• Excavation and drilling under the rail corridor

• Installation of a trench shield within the rail corridor

• Pulling ducting across the road to the rail corridor

• Installation of drainage within the road

• Reinstatement of the road surface

The equipment required will include:

• Excavators

• Hand tools

• Hot mix asphalt for the reinstatement of the road surface

• Noise mats to mitigate noise nuisance

• Lighting

Piling across the rail corridor - Update

As part of the works to widen the rail corridor under Mt Eden Road bridge for the new City Rail Link (CRL) lines, a series of foundation works are taking place with within our construction site to support the structure.

Mt Eden Road Bridge

From early July, the team will be installing sheet piles within the construction site by 97 Mt Eden Road. Sheet piles are segments of steel material that are driven into the ground using a crane with a vibrating attachment. These sheet piles are used to provide ground retention and support for future excavations.

The main impact from these works will be vibration from the piles being drilled into the ground, however attended monitoring will be performed to ensure we comply with the consented conditions.

These sheet piles will be installed in three locations on site (see blue areas on map below) and will take approximately two weeks in total to complete.

Normanby Road Over Rail Bridge - Piling update

In preparation for the Normanby Road over rail bridge, the team continues to drill piles and install sheet piles adjacent to the Temporary Services Bridge. This work will continue over the next 5 weeks.

The main impact from these works will be vibration from the piles being drilled into the ground, however attended monitoring will be performed to ensure we comply with the consented conditions.

Eastern Grade Separation on the rail corridor

The Eastern Grade Separation (EGS) is a series of complex works to accommodate the additional City Rail Link Northbound Line. Grade separation is a method of aligning the junction between two rail lines, which cross each other at different heights. A transitional trench from the East will dive below the Normanby Road over-rail bridge, in a northerly direction. The rail line will then enter the tunnel located at the Mt Eden station site, and travel towards Karangahape Road. The existing rail line will remain at ground level, travelling towards Kingsland. As part of the EGS works, a series of foundation works will take place within our construction site to support the structure.

The work will begin in mid July 2021 and will continue until early October 2021.

This work include:

• Tying and reinforcing steelwork

• Concrete pours for the foundations and roof slab

• Concrete breaking

• Erecting formwork

• The hours of work will be between 7am to 10pm, Monday to Saturday

The key equipment will include:

• Concrete trucks

• Excavators

• Crane

• Hand tools

• Noise mats to mitigate noise nuisance

• Lighting


Weekend work along the rail corridor, 10th - 11th July

To work on the existing rail tracks, Link Alliance utilises KiwiRail’s Block of Lines (BOL) which are short periods throughout the year when trains are not running on the rail network. The next BOL is Saturday 10th – Sunday 11th July.

Removal and installation of the Overhead Line Equipment (OHLE) masts and equipment

Saturday 10th and Sunday 11th July, 8am - 6pm

Where: Dominion Road overpass however the high-rail vehicle (HRV) will be accessing the rail corridor at Morningside

Equipment: High-rail vehicle, truck with hiab and trailer

What to expect: Likely impacts from noise and lights. Noise from plant and banging of steelwork with hammers. The high-rail vehicle is required to sound the horn before each movement. Vehicle and work lights will be used during reduced daylight in accordance with KiwiRail HRV plant operation rules and procedures.

Adjusting / removing rail hoardings Sunday 11 July from 2pm for 3-4 hours

Where: Dominion Road overpass

Scope of work: To allow access for other crews to complete their work, the hoardings need to be removed or relocated.

Equipment: Excavator and hand tools

What to expect: We expect there to be minimum noise and disruption. Vehicle movements.

Installing lighting and CCTV cameras Saturday 10th and Sunday 11th July, 8am - 6pm

Where: Temporary Services Bridge, Normanby Road

Scope of work: Continuation of work on the bridge in preparation for the opening of pedestrian access

Equipment: Hand tools

What to expect: We expect there will be minimum noise or disruption,

Various work at the rail level crossing Saturday 10th and Sunday 11th July, 8am - 6pm

Normanby Road bridge construction site

Scope of work:

• Removal of the flashing lights and bells from the crossing

• Installation of hoarding at Normanby Road level crossing

• Closing current pedestrian crossing and relocating to the Temporary Services Bridge

Equipment: Crane, excavator, hiab truck

What to expect: We expect there to be noise, vibration, truck movements and a change of the pedestrian route. To reduce the impact of our work we will be installing noise mats and cones to support way finding.

Various works at the rail corridor Saturday 10th and Sunday 11th July, 8am - 6pm

Where: Rail corridor between Normanby Road and Mt Eden Road

Scope of work:

• Installation and replacement of hoardings

• Excavation and installation of utilities ducts

Equipment: Excavators, dump trucks

What to expect: We expect there to be noise, vibration, truck movements. We will be installing noise mats to reduce noise impacts.


Works update- 23 June 2021

Normanby Road over rail bridge construction - Update

As part of the works to construct the new Normanby Road over rail bridge, a series of preparation works are commencing on the East side of Mt Eden.

Enfield Street footpath improvement

In preparation for when the Normanby Road level crossing is closed to pedestrians, and when people on foot are diverted over the new Temporary Services Bridge, Link Alliance are undertaking footpath improvement works on Enfield Street. This is to improve accessibility and to provide a suitable alternative route for those using a walking aid, pram, bike or scooter. The upgrade work includes installing tactiles on Enfield Street and upgrading sections of the footpath surface.

Roundabout and Boston Road island removal

On Saturday the 3rd of July the team will begin to remove the roundabout at Boston Road and replace it with a temporary structure. This is part of wider works to construct the Normanby Road over rail bridge and to redevelop the surrounding roads.

The removal will be carried out over the weekend in the day as well as during night works. Traffic management will be in place for the duration of the works and access to businesses will be maintained at all times.

Piling across the rail corridor - Update

As part of the works to widen the rail corridor under Mt Eden Road bridge for the new City Rail Link (CRL) lines, a series of foundation works are taking place with within our construction site to support the structure.

Mt Eden Road Bridge
From early July, the team will be installing sheet piles within the construction site by 97 Mt Eden Road. Sheet piles are segments of steel material that are driven into the ground using a crane with a vibrating attachment. These sheet piles are used to provide ground retention and support for future excavations.

The main impact from these works will be vibration from the piles being drilled into the ground, however attended monitoring will be performed to ensure we comply with the consented conditions.

These sheet piles will be installed in three locations on site (see blue areas on map below) and will take approximately two weeks in total to complete.

Normanby Road Over Rail Bridge - Piling update
 In preparation for the Normanby Road over rail bridge, the team continues to drill piles and install sheet piles adjacent to the Temporary Services Bridge. This work will continue over the next 6 weeks.

The main impact from these works will be vibration from the piles being drilled into the ground, however attended monitoring will be performed to ensure we comply with the consented conditions.


09 June 2021

Piling across rail Commencing early June 2021

Where: Normanby Road over rail bridge.

Scope of work: Preparation work for the Normanby Road over rail bridge. Drilling piles and sheet piling, adjacent to the temporary services bridge over the next 6 weeks.

Equipment: Crane, piling rig, trucks.

What to expect: Noise and vibration from piling rig. Noise mats will be used to mitigate noise nuisance. Truck movements.


02 June 2021

Update: Traffic light installation and line marking Commencing Early June 2021

Where: Normanby Road and Mt Eden Road intersection.

Scope of work: The work will include installing services and traffic light signals around the intersection and line marking on the road.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: This stage of works will be performed during the day. Traffic in both directions and pedestrian routes will be maintained. Traffic management will be in place. Noise mats will be used to mitigate noise nuisance.


Update: Install traffic light sensors under the road Commencing Early June 2021 Night works

Where: Normanby Road and Mt Eden Road intersection.

Scope of work: The work will include installing sensors under the road for the traffic lights around the intersection as well as line marking on the road.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: The Normanby Road and Mt Eden Road intersection will be closed. This stage of works will be performed at night over a series of days. Traffic management will be in place and a detour will be implemented. Noise mats will be used to mitigate noise nuisance. Pedestrian access will be maintained.


Update: Install traffic light sensors under the road Commencing Early June 2021 Night works

Where: Boston Road and Mt Eden Road intersection.

Scope of work: The work will include installing sensors under the road for the traffic lights around the intersection as well as line marking on the road.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: The Boston Road and Mt Eden Road intersection will be closed. This stage of works will be performed at night over a series of days. Traffic management will be in place and a detour will be implemented. Noise mats will be used to mitigate noise nuisance. Pedestrian access will be maintained.


31 May 2021

Upcoming works

We are continuing to undertake extensive excavation, service upgrades and foundation work, in preparation for the future City Rail Link tunnels and re-developed Mt Eden Station. Over the coming weeks, the following activities will take place in zone 1 and 2 below:

Installation of Utility Services – Night Work, Weekend Work, Temporary Road Closures

As part of the preparation works to remove the current Normanby Road level crossing and construct the new Normanby Road over rail bridge, services are being diverted around Mt Eden.

What & When: Update: Removal of Vector high voltage cables Commencing June 2021

Where: Normanby Road (Eastern Side)

Scope of work: Excavation of high voltage cables, backfill the excavation and reinstate the area.

Equipment: Excavator, concrete breaker, hydro/air excavator, compactor, trucks

What to expect: Traffic management will be in place. Traffic in both directions will be maintained. Pedestrian routes will be diverted when required. Noise and vibration from excavation and compacting. Noise mats will be used to mitigate noise nuisance.


What & When: Update: Ongoing installation of utilities on the Boston Road footpath Commencing May to Early June

Night Work Weekend Work

Where: Boston Road footpath (Western Side)

Scope of work: Night works and weekend work will be required to isolate the existing services within the footpath and connect the new services to the temporary services bridge.

Equipment: Excavator, concrete breaker, compactor, hand tools, grinder machine, welding equipment, trucks, light tower

What to expect: Traffic management will be in place and detours may be implemented when necessary. Night work will be required to connect the new utility services to the temporary services bridge. Noise mats will be used to mitigate noise nuisance.


What & When: Update: Ongoing installation of utilities on Boston Road Commencing May to Early June

Night Work Weekend Work

Where: Boston Road (Western Side)

Scope of work: There will be a temporary closure of the Westbound lane on Boston Road. Night work is required to isolate the existing services within the road and connect the new services to the temporary services bridge (see map below).

Equipment: Concrete breaker, excavator, compactor, hand tools, grinder machine, welding equipment, trucks, light tower.

What to expect: Traffic management will be in place and detours may be implemented when necessary. Night work will be required to connect the new services to the temporary services bridge. Noise mats will be used to mitigate noise nuisance.


What & When: Update: Temporary Services Bridge - Continued installation of services Commencing May to Mid June

Night Work Weekend Work

Where: Normanby Road

Scope of work: Installation of water, electrical, and waste water services to the bridge span. This bridge will also be used as a temporary pedestrian bridge once the level crossing is removed.

Equipment: Hand tools, grinder machine, welding equipment, trucks, elevated work platforms, light tower.

What to expect: Weekend work and night work is required for service connections to ensure safe working conditions above the rail lines. Crews will be grinding and welding along the bridge span as well as pressure testing the watermain. Noise mats will be used to mitigate noise nuisance.


What & When: Update: Installation of wastewater services on Boston Road

Weekend closures (24/7) - 6am Saturday to 7pm Monday

• 5 to 7 June

• 12 to 13 June

• 19 to 20 June

Mid week night closures - 9pm to 5am

• 14 to 18 June

Where: Boston Road (Eastern Side)

Scope of work: Excavation outside 49 Boston Road is required to isolate the existing services within the road and connect the new wastewater services (see map below).

Equipment: Concrete breaker, excavator, compactor, hand tools, small crane, grinder machine, welding equipment, trucks, hot mix asphalt, light tower.

What to expect: For the weekend work listed above, there will be a temporary road block for the duration of the weekend.

For the night work listed above, temporary road blocks will be required from 9pm to 5am.

Noise mats will be used to mitigate noise nuisance. Traffic management will be in place and detours will be implemented.



20 May 2021

Queen's Birthday weekend - Block of Line work


As part of the ongoing work to build the additional CRL line, we will be working on a variety of activities in the rail corridor over Queen's Birthday weekend during Block of Line, when the trains are not running.

Various works in rail corridor 5 June to 7 June (Queen's Birthday weekend)

Where: In the rail corridor - east of the station (zones 1 and 2)

Scope of work:

• Timber hoarding installation - Normanby Road

• Service removal - Normanby Road

• Track removal, excavation and formation

• Installation of under-track utilities

• Removal of ballast and rock breaking through basalt

Equipment: Digger, excavator, hand tools, rock breaker, compactor, concrete trucks, roller.

What to expect: This work will involve removing the existing track and sleepers. There will also be ongoing excavation on site, installation of under-track services and formation of new tracks. Where possible, noise mats will be used to mitigate noise disruption.

Installation of wastewater services on Boston Road 5 June to 7 June - Weekend road closure

Where: Boston Road (Eastern Side)

Scope of work: Excavation outside 49 Boston Road is required to isolate the existing services within the road and connect the new wastewater services (see map below).

Equipment: Concrete breaker, excavator, compactor, hand tools, small crane, grinder machine, welding equipment, trucks, hot mix asphalt, light tower.

What to expect:

To enable this work, there will be a temporary road closure for the duration of the weekend.

Noise mats will be used to mitigate noise nuisance. Traffic management will be in place and detours will be implemented.



05 May 2021

We are continuing to undertake extensive excavation, service upgrades and foundation work, in preparation for the future City Rail Link tunnels and re-developed Mt Eden Station. Over the coming weeks, the following activities will take place in zone 1 and 2:

Installation of Utility Services on the Temporary Services Bridge – Night Work, Weekend Work, Temporary Road Closure

As part of the preparation works to remove the current Normanby Road level crossing and construct the new Normanby Road over rail bridge, services are being diverted around Mt Eden.

Ongoing installation of utilities on the Boston Road footpath

Commencing 15 May to Early June

Where: Boston Road footpath (Western Side)

Scope of work: Night works and weekend work will be required to isolate the existing services within the footpath and connect the new services to the temporary services bridge.

Equipment: Excavator, concrete breaker, compactor, hand tools, grinder machine, welding equipment, trucks, light tower

What to expect:

Traffic management will be in place and detours may be implemented when necessary. Night work will be required to connect the new utility services to the temporary services bridge. Noise mats will be used to mitigate noise nuisance.

Ongoing installation of utilities on Boston Road

Commencing 24 May to 28 May

Where: Boston Road (Western Side)

Scope of work: There will be a temporary closure of the Westbound lane on Boston Road. Night work is required to isolate the existing services within the road and connect the new services to the temporary services bridge (see map below).

Equipment: Concrete breaker, excavator, compactor, hand tools, grinder machine, welding equipment, trucks, light tower.

What to expect: Traffic management will be in place and detours may be implemented when necessary. Night work will be required to connect the new services to the temporary services bridge. Noise mats will be used to mitigate noise nuisance.

Temporary Services Bridge -Continued installation of services

Commencing 17 May to early June

Where: Normanby Road

Scope of work: Installation of water, electrical, and waste water services to the bridge span. This bridge will also be used as a temporary pedestrian bridge once the level crossing is removed.

Equipment: Hand tools, grinder machine, welding equipment, trucks, elevated work platforms, light tower.

What to expect: Weekend work and night work is required for service connections to ensure safe working conditions above the rail lines. Crews will be grinding and welding along the bridge span as well as pressure testing the watermain. Noise mats will be used to mitigate noise nuisance

Installation of wastewater services on Boston Road

15 May to 16 May - 48 hour Closure

22 May to 23 May - 48 hour Closure

29 May to 30 May - 48 hour Closure

24 May to 4 June - Night Closures from 9pm to 5am

Where: Boston Road (Eastern Side)

Scope of work: Excavation outside 49 Boston Road is required to isolate the existing services within the road and connect the new wastewater services (see map below).

Equipment: Concrete breaker, excavator, compactor, hand tools, small crane, grinder machine, welding equipment, trucks, hot mix asphalt, light tower.

What to expect: For the weekend work listed above, there will be a temporary road block for the duration of the weekend.

For the night work listed above, temporary road blocks will be required from 9pm to 5am.

Noise mats will be used to mitigate noise nuisance. Traffic management will be in place and detours will be implemented.





01 May 2021

Mt Eden/ Normanby Road Intersection and Mt Eden/ Boston Road Intersection Traffic Light Installation, Night Works, Road Closures, Weekend Work

To prepare for the closure of the Normanby Road level crossing and to enable the construction of the Normanby Road over rail bridge, we will be installing traffic lights at the Mt Eden/ Normanby Road intersection, and the Mt Eden/ Boston Road intersection. Closing the level crossing permanently will improve peoples safety by separating people, cars and trains. This work will be completed in stages to minimise disruption, as detailed in the tables below.


Temporary removal of 4 carparks Commencing May 2021

Where: Normanby Road and Mt Eden Road intersection.

Scope of work: The work will include the temporary removal of 4 parking spaces to allow for a signalised pedestrian crossing and signalised cycle lanes which has been previously notified.

What to expect: This stage of works will be performed during the day. Traffic in both directions and pedestrian routes will be maintained. Traffic management will be in place. Noise mats will be used to mitigate noise nuisance.


Removal of the existing road median and traffic island Commencing 5 May to 12 May

Where: Normanby Road and Mt Eden intersection.

Scope of work: The work will include removing the existing road median and traffic island in the center of the road, to enable traffic light installation which has been previously notified.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: This stage of works will be performed during the day. Traffic in both directions and pedestrian routes will be maintained. Traffic management will be in place. Noise mats will be used to mitigate noise nuisance.


Traffic light installation Commencing 12 May to 30 May

Where: Normanby Road and Mt Eden Road intersection

Scope of work: The work will include installing services and traffic light signals around the intersection.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: This stage of works will be performed during the day. Traffic in both directions and pedestrian routes will be maintained. Traffic management will be in place. Noise mats will be used to mitigate noise nuisance.


Installation of power ducts across the road

Commencing 8 May to 9 May

15 May to 16 May

22 May to 23 May

29 May to 30 May

Where: Normanby Road and Mt Eden Road intersection.

Scope of work: The work will include installing services across the road which will supply power to the traffic lights around the intersection.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: This stage of works will be performed during the day over the weekend. Traffic management will be in place and detours may be implemented when necessary. Noise mats will be used to mitigate noise nuisance. Pedestrian access will be maintained.


Install traffic light sensors under the road Commencing 24 May to 30 May

Where: Normanby Road and Mt Eden Road intersection.

Scope of work: The work will include installing sensors under the road for the traffic lights around the intersection as well as line marking on the road.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect:

The Normanby Road and Mt Eden Road intersection will be closed. This stage of works will be performed at night over a series of days. Traffic management will be in place and a detour through Edwin Street and Esplanade Road (respectively) will be implemented at times. Noise mats will be used to mitigate noise nuisance. Pedestrian access will be maintained.


Boston Road and Mt Eden Road Intersection Temporary removal of 8 carparks Commencing May 2021

Where: Mt Eden Road and Boston Road intersection

Scope of work: The work will include the temporary removal of 8 parking spaces to allow for the widening of Boston Road, installation of traffic lights and the addition of a second traffic lane from Boston Road to Mt Eden Road (see map below).

What to expect: This stage of works will be performed during the day. Traffic in both directions and pedestrian routes will be maintained. Traffic management will be in place. Noise mats will be used to mitigate noise nuisance.


Removal of the existing kerb and relocation of the traffic light poles (southern side) Commencing 5 May to 14 May

Where: Boston Road and Mt Eden Road intersection.

Scope of work: The work will include removing the existing kerb and relocating the traffic light poles at the intersection.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: This stage of works will be performed during the day. Traffic management will be in place. Traffic in both directions and pedestrian routes will be maintained. Noise mats will be used to mitigate noise nuisance.


Relocate traffic light signal poles and reinstate the traffic island (Northern side)

Commencing

8 May to 9 May

15 May to 16 May

22 May to 23 May

29 May to 30 May

Where: Boston Road and Mt Eden Road intersection.

Scope of work: The work will include the relocation the traffic light signal poles and the construction of the new traffic island in the road.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect: This stage of works will be performed during the day over the weekend. Traffic management will be in place and detours may be implemented when necessary. There will be a no left turn from Mt Eden Road to Boston Road. Access to Boston Road from the Southern side will remain open. Noise mats will be used to mitigate noise nuisance. Pedestrian access will be maintained.


Traffic light sensors under the road Commencing 24 May to 30 May

Where: Boston Road and Mt Eden Road intersection.

Scope of work: The work will include installing sensors under the road to for the traffic light signals around the intersection, as well as line marking on the road.

Equipment: Excavator, concrete breaker, trucks, compactors, hot mix asphalt.

What to expect:

The Boston Road and Mt Eden Road intersection will be closed. This stage of works will be performed at night over a series of days. Traffic management will be in place and a detour will be implemented at times. Noise mats will be used to mitigate noise nuisance. Pedestrian access will be maintained.


Installation of services – Night Work, Weekend Work

As part of the preparation works to remove the current Normanby Road level crossing and construct the Normanby Road over rail bridge, services are being diverted around Mt Eden.

What & When: Temporary Services Bridge - Continued installation of services Commencing18 April ongoing

Where: Normanby Road

Scope of work: Installation of water, electrical, and waste water services to the bridge span. This bridge will also be used as a temporary pedestrian bridge once the level crossing is removed.

Equipment: Hand tools, grinder machine, welding equipment, trucks, elevated work platforms, light tower.

What to expect: Weekend work and night work is required for service connections to ensure safe working conditions above the rail lines. Crews will be grinding and welding along the bridge span. Noise mats will be used to mitigate noise nuisance.


Removal of the old high voltage cables Commencing May 2021

Where: Normanby Road (Eastern side) Nugent Street (Western Side)

Scope of work: Excavation of the high voltage cables, backfill and reinstate the road.

Equipment: Excavator, concrete breaker, road saw, hydro/air excavator, compactor, trucks.

What to expect: Traffic management will be in place. Traffic in both directions and pedestrian routes will be maintained. Noise and vibration from excavation and compacting. Noise mats will be used to mitigate noise nuisance. Truck movements. Hot mix asphalt.


Piling across rail corridor Commencing May 2021

Where: Normanby Road over rail bridge.

Scope of work: Preparation work for the Normanby Road over rail bridge. Drilling 17 piles adjacent to the temporary services bridge over 6 weeks.

Equipment: Crane, piling rig, trucks.

What to expect: Noise and vibration from piling rig. Noise mats will be used to mitigate noise nuisance. Truck movements.


Mt Eden Road Bridge - Ongoing Site Preparation Works, Night Works, Weekend Work, Road Closure

Works around 97 Mt Eden Road are ongoing as part of extending the existing Mt Eden road over rail Bridge for the future City Rail Link tunnels.

What & When: Laying asphalt on the Mt Eden Bridge road (West side) Commencing 26 May to 3 June

Where: Mt Eden Road over rail bridge

Scope of work: The work with involve laying asphalt over the new Mt Eden Bridge as well as line marking.

Equipment: Paving machine, roller, compactor, hot mix asphalt, trucks.

What to expect: To support the asphalt works there will be a full closure on Mt Eden Road between Water Street and Enfield Street from 9pm to 5am. To mitigate the impacts to our surrounding neighbours, fences and noise mats will surround the work site to reduce noise, and noise monitoring will be in place.


Ongoing site preparation for the Mt Eden Road over rail bridge Commencing 10 April to July

Where: Mt Eden Road over rail bridge

Scope of work: Concrete breaking, excavation, steel work, sheet piling,

Equipment: Concrete breaker, excavator, power tools, air compressor, small crane, trucks.

What to expect: There will be ongoing concrete breaking, and excavation, steel works, piling and truck movements. Weekend work, night work and temporary closures will be required at times to support the construction of the road over rail bridge.


Northbound Lane -Temporary closure Commencing 17 April 2021 Normanby Road

Scope of work: Identify underground services before the installation of the new watermain pipeline.

Duration: Approximately one day, 7am to 6pm.

Equipment: Road saw, hydro-excavator, plate compactor, 6-wheeler trucks, hot mix asphalt.

What to expect:

  • Northbound lane closure - required to ensure safe conditions whilst working in the road corridor

  • Access for businesses and residents will be maintained at all times

  • Noise mats will be used to mitigate noise nuisance

  • Traffic management in place

  • Truck movements


Temporary Services Bridge - Continued installation of services Commencing 18 April 2021 Normanby Road

Scope of work: Installation of services to main steel truss and bridge span

Duration: Approximately one week (weather dependent)

Equipment: Hand tools, grinder machine, welding equipment, trucks delivering materials, elevated work platforms (EWPs), light tower.

What to expect:

• WEEKEND WORK - Sunday work required

• NIGHT DELIVERIES – Deliveries will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

• NIGHT WORKS required for service connections on Normanby Road bridge pier to ensure safe working conditions above OHLE wires

• Crews grinding and welding along the bridge span, using EWPs for height access

• Traffic management in place

• Truck movements


Thank you for your feedback

The consultation for the Normanby Road temporary parking removal has now closed.

Your feedback on these proposed changes is very important to us, whether you supported the proposal or had concerns about it. Feedback and questions from this survey will be sent to Auckland Transport for review.


Temporary road closure at night -Installation of Watermain pipeline Commencing 29 March 2021 Normanby Road

Scope of work:

We will use an excavator to remove the temporary road plates and lay the new watermain pipeline. This work is required to divert the existing watermain located within Normanby Road. We will reinstate the road plates at the end of each shift to allow vehicle access.

Duration: Approximately one week (weather dependent)

Equipment: Excavator, plate compactor, road saw, vibratory excavator, concrete breaker, hydro-excavator, welding generator, light tower.

What to expect:

• ROAD CLOSURE AT NIGHT

• NIGHT WORKS - Noise and vibration from saw cutting of the existing asphalt, excavation, compacting materials, installation of watermain pipeline and installation of temporary road plates for non-working time access

• Fencing and noise mats will be used to mitigate noise and light nuisance

• Truck movements

• Hot mix asphalt


Temporary road closure -Installation of Watermain pipeline Commencing 23 April to 27 April 2021 Normanby Road

Scope of work:

Removal of the temporary road plates, saw cutting and draining the existing watermain. We will then connect the new watermain pipeline before backfilling the trench.

Duration: ANZAC Weekend - 23 to 27 April

Equipment: Excavator, rock breaker, welding equipment, road saw, vibratory excavator, concrete breaker, vibro-roller, plate compactor, 6-8 wheel trucks.

What to expect:

  • ROAD CLOSURE 24/7 - from 9pm, 23 April to 10pm, Tuesday 27 April.

  • NIGHT WORKS - Noise and vibration from excavating and compacting. This work will be monitored to ensure compliance

  • Noise mats and fencing will be used to mitigate noise and light nuisance

  • Truck movements

  • Hot mix asphalt


Work on Mt Eden Road Bridge - from 10 April

WEEKEND WORK - Site preparation for bridge foundation Commencing 10 April 2021

Where: Mt Eden Road Bridge - within 97 Mt Eden Road site

Scope of work: Concrete breaking and excavation works

Duration: Approximately two days

Equipment: Excavator, concrete breaker, 6 wheeler trucks

What to expect:

  • WEEKEND WORK – Concrete breaking and excavation to be carried out on Saturday 10 April with a possibility of Sunday 11 April

  • Hours of work will be adjusted to prevent noise nuisance

  • Noise and vibration will be monitored to ensure compliance

  • Truck movements


Ongoing site preparation Commencing 10 April to May 2021

Where: Mt Eden Road Bridge - within 97 Mt Eden Road site

Scope of work: Concrete breaking, excavation, steel work

Duration: Approximately five weeks (weather dependent)

Equipment: Excavator, concrete breaker, power tools, air compressor, small crane, 6 wheeler trucks.

What to expect:

Concrete breaking and excavation

  • Noise and vibration will be monitored to ensure compliance

  • Truck movements


NIGHT WORKS - Concrete pour Commencing 27 April until 30 April 2021(weather dependent)

Where: Mt Eden Road Bridge - Within 97 Mt Eden Road site

Scope of work: Concrete pour to construct the western side of Mt Eden Road Bridge platform

Duration: Approximately one night (weather dependent)

Equipment: Concrete truck, hand tools, trucks delivering materials, light tower.

What to expect:

  • NIGHT WORKS required to ensure safe working conditions

  • Noise and vibration will be monitored to ensure compliance

  • Truck movements


Installation of services on Normanby Road - from 12 April

Installation of services Commencing 12 April 2021 Normanby Road

Scope of work: Excavation of existing footpath and installation of services

Duration: Approximately three weeks (weather dependent)

Equipment: Excavator, concrete breaker, hand tools, hydro excavator, trucks delivering materials.

What to expect:

  • Noise and vibration will be monitored to ensure compliance

  • Truck movements

  • Traffic management will be in place


Normanby Road Bridge Preparation - from 19 April

Piling along rail corridor Commencing 19 April 2021 Normanby Road Bridge

Scope of work: Preparation work for the Normanby, road-over-rail bridge.

Drilling 17 piles adjacent to the temporary services bridge.

Duration: Approximately six weeks (dependent on ground conditions)

Equipment: Crane, piling rig, trucks delivering materials

What to expect:

  • Noise and vibration from piling rig

  • Truck movements


Ongoing Temporary Services Bridge works - from 19 April

Temporary Services Bridge - Continued installation of services Commencing 19 April 2021 Normanby Road

Scope of work: Installation of services to main steel truss and bridge span

Duration: Approximately one week (weather dependent)

Equipment: Hand tools, grinder machine, welding equipment, trucks delivering materials, elevated work platforms (EWPs), light tower.

What to expect:

  • NIGHT DELIVERIES – Deliveries will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

  • NIGHT WORKS required for service connections on Normanby Road bridge pier to ensure safe working conditions above OHLE wires

  • Crews grinding and welding along the bridge span, using EWPs for height access

  • Traffic management in place

  • Truck movements


Temporary road closure at night - Installation of Watermain pipeline Week Commencing 29 March

Where: Normanby Road

Scope of work:

We will use an excavator to remove the temporary road plates and lay a new watermain pipeline. This work is required to divert an existing watermain located within Normanby Road. We will reinstate the road plates at the end of each shift to allow for vehicle access during the installation of pipework and manholes.

Duration: Approximately one week

Equipment:

Excavator, plate compactor, road saw, vibratory excavator, concrete breaker, hydro-excavator, welding generator, light tower

What to expect:

  • ROAD CLOSURE AT NIGHT - From 9pm to 5am

  • NIGHT DELIVERIES - Deliveries will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

  • NIGHT WORKS - Noise and vibration from saw cutting of the existing asphalt, excavation, compacting materials, installation of watermain pipeline and re-installation of temporary road plates

  • Fencing and noise mats will be used to mitigate noise and light nuisance


Temporary road closure - Installation of Watermain pipeline 23 to 26 April 2021 Normanby Road

Scope of work:

We will be removing the road plates, saw cutting and draining the existing watermain. We will then connect the new watermain pipeline before backfilling the trench.

Duration: Anzac Weekend - 23 to 26 April

Equipment: Excavator, rock breaker, welding equipment, road saw, vibratory excavator, concrete breaker, vibro-roller, plate compactor, 6-8 wheel trucks.

What to expect:

ROAD CLOSURE 24 HOUR WORKS -

  • Friday 23 April 9pm to Monday 26 April 10pm

  • NIGHT DELIVERIES - Deliveries will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

  • NIGHT WORKS - Noise and vibration from excavation and compacting materials will be monitored to ensure compliance

  • Noise mats and fencing will be used to mitigate noise and light nuisance

  • Trucks removing spoil and delivering materials

  • Hot mix asphalt


Erect Temporary Services Bridge steel columns and main truss bridge span Week commencing 1 March Normanby Road

Scope: Install steel column sections to each bridge pier, main steel truss bridge span and earthing and bonding

Time: Approximately two weeks:

  • One week – install steel and earthing and bonding

  • One week – connect services column to truss

Equipment: 200 tonne mobile crane, excavator, rattle guns, hand tools, welding equipment, trucks delivering materials, elevated work platforms (EWPs)

  • NIGHT WORKS required to install columns, main truss bridge span and earthing and bonding

  • NIGHT DELIVERIES – main bridge span delivery will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

  • NIGHT WORKS required for service connections on Normanby Road bridge pier to ensure safe working conditions above OHLE wires

  • Some noise and lights from the crane lifting columns and truss into place

  • Crews welding bridge span to columns using EWPs for height access

  • Traffic management in place

  • Trucks delivery materials to site


Emergency maintenance works Feb 7 to 11

Carried out by City Rail Link on behalf of KiwiRail.

Commencing on 7 February until 11 February we will be conducting night works in the rail corridor between Akiraho Street and Normanby Road.

Track inspection and cutting of rail 12am to 4am, Sunday 7 February Within the rail corridor near 1 Akiraho Street

This emergency night work will include inspecting the rail tracks and cutting sections of track. There will be high-rail vehicles used to inspect the tracks.
Equipment will be used to cut the trail tracks.
Noise mitigation will be used where possible.

What to expect:

  • High rail vehicles will be used to inspect the rail tracks.

  • The rail cutting may be noisy and will last for short periods.


Track inspection and ballasting 12am to 4am, Monday 8 February

Within the rail corridor by Enfield Street.

Ballast stones will be laid upon the rail track in this section. The ballast stones help form the track bed, offering stabilisation, drainage and preventing vegetation growth along the rail corridor.

Equipment: High rail vehicles used to inspect the tracks.
Excavators.

What to expect: Noise nuisance should be restricted to placement of the ballast stones.


Realignment of track 12am to 4am Tuesday 9 February

Within the rail corridor between Akiraho Street and Normanby Road.

A tamper machine will measure, lift and realign the rail. The machine will also pack the ballast stones underneath the rails to support them.

Equipment: KiwiRail’s mechanised tamper rail vehicle which lifts and realigns the rails will be used

What to expect: This section of emergency maintenance work is likely to be noisy. Noise mitigation will be used where possible to minimise the impact.


Welding of rail tracks 12am to 4am Wednesday 10 February

Within the rail corridor between Akiraho Street and Normanby Road This emergency night works will include welding small lengths of the rail track.

Equipment: High rail vehicles and welding equipment.

What to expect:

  • This section of emergency maintenance work will be done intermittently and may be noisy.

  • Noise mitigation will be used where possible to minimise the impact.


Welding of rail tracks 12am to 4am Thursday 11 February

Within the rail corridor between Akiraho Street and Normanby Road.
This emergency night works will include welding small lengths of the rail track.

Equipment: High rail vehicles and welding equipment.

What to expect:

  • This section of emergency maintenance work will be done intermittently and may be be noisy.

  • Noise mitigation will be used where possible to minimise the impact.

As with all our construction activity, we will be monitoring for noise, dust and vibration and have monitoring equipment in place that will alert us if we are going over set limits. We will also be:

  • Using attended monitoring during construction to measure noise and vibration levels so we can make adjustments to our construction methods, if necessary

  • Receiving deliveries within normal working hours (where possible)

  • Scheduling concrete deliveries within normal working hours (where possible)

  • Keeping you informed and giving plenty of advance notice about any works that need to take place outside of normal working hours

We’ll be working between 7am and 10pm Monday to Friday and 7am – 7pm on Saturday.

We will keep you informed regarding any work that falls outside of these hours, further details and any changes.


Bored piling continuing till end February 2021

Where: Within the rail corridor, between Normanby Road and Auburn Street (see below image)

Scope of work Install bored piles within the rail corridor to create the retaining wall for the trench. The auger will drill down approx 20 meters and then place the reinforcing cage which will be filled with concrete. This work will enable us to retain the earth for late excavation work.

Duration: Approximately one month to complete

Equipment: Support crane to lift cages and place concrete, piling rig with auger attached, concrete trucks, diggers to remove spoil, trucks.

What to expect:

  • Noise and vibration from piling, excavation

  • Trucks removing spoil and delivering materials

Excavating and installing block retaining wall- commencing 1 February

Where: Within the rail corridor, between Normanby Road and Severn Road (see below image)

Scope of work: Excavate and hydrovac the area to provide sufficient area for the installing of a block retaining wall

Duration: Approximately six weeks

Equipment:  Excavator with bucket attachment, hydrovac, six wheel truck

What to expect:

  • Some noise and vibration from excavation and hydrovac

  • Trucks removing spoil

Site preparation for future works- commencing end of January

Where: Within the Link Alliance site, corner Boston Road and Normanby Road

Scope of work: Remove existing crib wall which bounds the edge of the footpath and then pre-load the area with additional fill to approx 4 meters. This will match the height of the road once we have completed the work to relocate the roundabout which is proposed to start at the end of 2021.

Duration: Approximately three months

Equipment Excavator, compactor, roller, trucks removing materials and delivering fill

What to expect:

  • Noise and vibration from excavation, removing and reinstating fill

  • Trucks removing materials and delivering materials


Utilities Crossing Installations- Saturday 13 & Sunday 14 February

Where: Nugent Street

Scope of work: Concrete breaking, trench excavation, install utilities, backfill, level the road and reinstate asphalt

Duration 7am Saturday 13 Feb to 9pm Sunday 14 Feb

Equipment: Excavator with bucket attachment and concrete breaker, hydrovac, compactor, 6-8 wheel trucks

What to expect:

  • Noise and vibration from excavation and compacting

  • Road closure and traffic detour in place

  • Traffic management in place to maintain pedestrian and vehicle access to properties

  • Working hours - 7am - 7pm, both days


Erect Temporary Services Bridge steel columns and main truss bridge span- week commencing 15 February

Where: Normanby Road

Scope of work: Install steel column sections to each bridge pier, main steel truss bridge span and earthing and bonding

Duration: Approximately two weeks. One week – install steel and earthing and bonding. One week – connect services column to truss

Equipment: 200 tonne mobile crane, excavator, rattle guns, hand tools, welding equipment, trucks delivering materials, elevated work platforms (EWPs)

What to expect:

  • NIGHT WORKS required to install columns, main truss bridge span and earthing and bonding

  • NIGHT DELIVERIES – main bridge span delivery will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

  • NIGHT WORKS required for service connections on Normanby Road bridge pier to ensure safe working conditions above OHLE wires

  • Some noise and lights from the crane lifting columns and truss into place

  • Crews welding bridge span to columns using EWPs for height access

  • Traffic management in place

  • Trucks delivery materials to site


Boston Road closing between Mt Eden Road and the roundabout

The road will be closed from 7am on Saturday 23 January until 7pm on Sunday 24 January, however our working hours will be 7am to 7pm each day. We will be digging a trench within Boston Road to install communications ducts for use on the yet to be built, temporary services bridge.

You may experience some noise however we will surround the site with noise reducing matts to help minimise any noise disruption.

When: 7am Saturday 23 January to 7pm Sunday 24 January

Where: Boston Road between Mt Eden Road and the roundabout

Equipment: A small excavator, hydrovac truck, concrete saw and rock breaker will be used to create a trench enabling the utilities team to work on the below ground services.

Scope of work:

  • A full road closure will be in place on Boston Road between Mt Eden Road and the roundabout.

  • Traffic Controllers will be on hand to maintain access to private properties within the road closure.

  • Some noise may be experienced from the concrete cutter and hydrovac truck, however sound reducing matts will surround the site to help minimise any noise disruption.

  • Access to all private properties will be retained.


Sheet piling continues Wednesday 2 December 2020

Where: Within the rail corridor, between Normanby Road and Auburn Street

Scope of work: Install 300 x temporary sheet piles within the rail corridor to provide soil retention, excavation support and a safety barrier. Sheet piles are sections of sheet steel with interlocking edges that are vibrated into the ground to form a wall (see image below). An excavator-mounted vibro-hammer will be used to place the piles into position.

Duration: Approximately one month to complete

Sheet piling - 2 - 18 December 20
To complete the section of works farthest away from the live up-main

Sheet piling - 26 December 20 - 08 January 21
To complete the section of work closest to the up-main during the Christmas Block of Line

Sheet Piling - 9 - 31 January
Contingency dates to complete the works

Equipment: Excavator with vibro-hammer attachment, low bed transporter, flat deck truck delivering sheet piles, support crane, excavator with bucket attachment (concrete breaker if required).

What to expect:

  • Noise and vibration from piling, excavation and obstruction breaking if required

  • Trucks removing spoil and delivering materials



Night works - Utility investigations Monday 7 December 7.00pm to 5.00am

Where: Within the rail corridor, between Normanby Road and Severn Road


Track Formation & Drainage Works - Saturday 26 December 2020

Where: Within the rail corridor (starting opposite 33 Boston Road and progressing West towards the motorway overpass)

Scope: Remove existing ballast and track formation, excavate under the existing down main railway track, construct new track formation (subgrade and subsoil levels) and drainage, reinstate ballast and sand drag. The subgrade is the native material that lies underneath a constructed road or railway track. It is made up of layers of granular material such as sand, gravel and crushed stone. This granular material is combined with layers of geosynthetic materials such as geogrid and geotextile that are used to reinforce and stabilise soil behind retaining walls.

Duration: About a week

Equipment: Excavator, compactor, roller, trucks removing materials and delivering ballast

What to expect:

  • Noise and vibration from excavation, track formation, removing and reinstating ballast

  • Trucks removing materials and delivering materials


Asphalt Repairs and Slot Trench holes - 28 December 2020 (contingency date 4 January 2021)

Where: Normanby Road

Scope: Asphalt Repairs – backfill and level the road, reinstate asphalt (may include night works)

Slot Trench holes – concrete breaking, trench excavation for trial holes, backfill, level the road and reinstate asphalt

Duration: About one week

Equipment: Excavator with bucket attachment and concrete breaker, hydrovac, compactor, 6-8 wheel trucks

What to expect:

  • Noise and vibration from excavation and compacting

  • Road shoulder closure in place - two-way traffic maintained

Traffic management in place to maintain pedestrian and vehicle access to properties.

^ back to top


Excavation behind Sheet Piling Retaining Walls - Monday 28 December 2020

Where: Within the rail corridor – between Normanby Road and Auburn Street

Scope: Excavate behind the sheet piles to relieve pressure build up behind the sheet piles once future excavation occurs to a depth of six meters (maximum build up of soil behind the sheet piles is approximately three meters)

Duration: About one week

Equipment: Excavator, 6-8 wheel trucks

What to expect:

  • Some noise from excavation

  • Trucks removing spoil

^ back to top


Install ducting under the rail corridor - Tuesday 29 December 2020

Where: Within the rail corridor, between Normanby and Severn Road

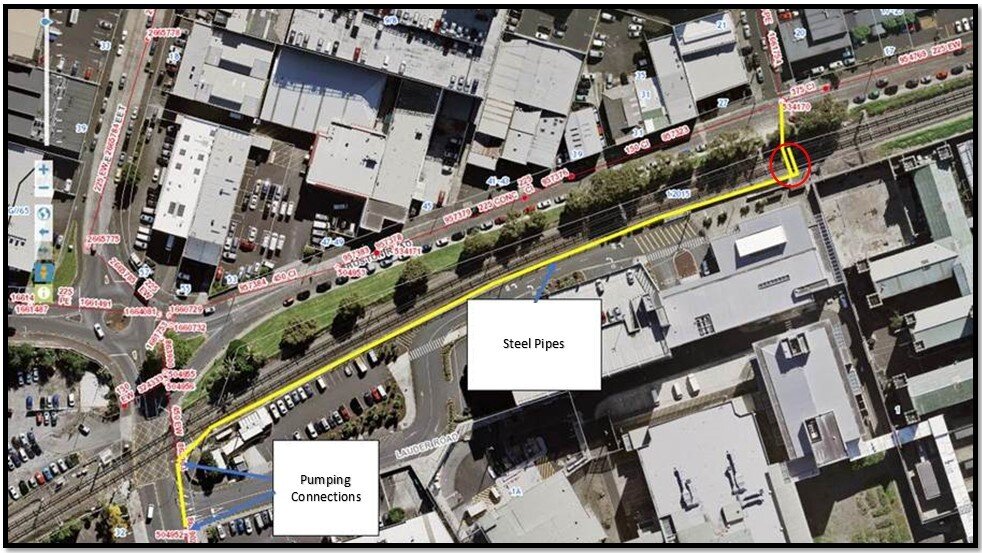

Scope: Excavate and install steel pipes for temporary ducting under the rail corridor, opposite Auburn Street (circled in red in the image below)

Duration: About three days

Equipment: Excavator with bucket attachment, hydrovac, hi-ab truck, excavator with grab attachment

What to expect: Noise and vibration from excavation, lifting pipe into place, backfilling and compacting material


Installation of Rail Separation Hoardings - Monday 4 January 2021

Where: Within the rail corridor – Between Normanby Road and Auburn Street

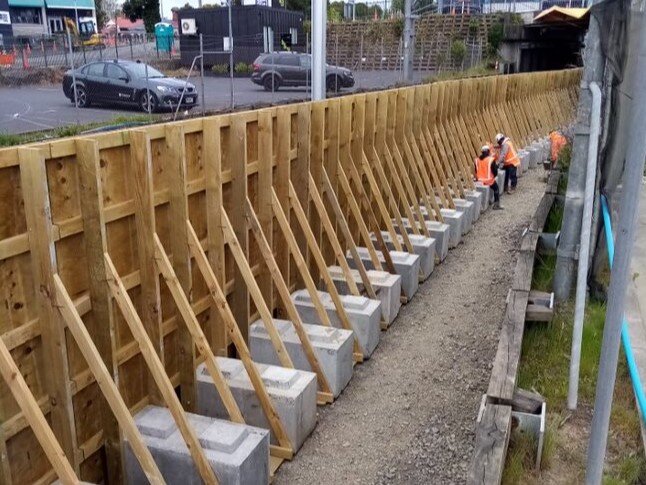

Scope: Install a gravity concrete block hoarding with pre-fabricated timber frames and timber hoarding panels. (Similar to the image to the right).

To install the gravity block hoarding we’ll use a hi-ab truck, and telehandler if required, to lift the frames and blocks into place then attach the timber panels and diagonal bracing with hand tools. Trucks will be delivering materials.

Duration: About two weeks

Equipment: Hi-ab truck, telehandler, generator for powered tools, hand tools – tension control bolt/hydraulic wrench or manual torque wrench

What to expect:

  • Trucks delivering concrete blocks to site

  • Hi-ab truck and telehandler lifting concrete blocks, prefabricated frames and panels into place

  • Some noise from timber panels and diagonal bracing being attached.

^ back to top


Utilities Crossing Installations - 9 – 10 January 2021 and 16 – 17 January 2021

Where: Boston Road – 9 - 10 January 2021 (contingency date 23 - 24 January 2021) Nugent Street – 16 - 17 January 2021 (see images below)
Scope: Concrete breaking, trench excavation, install utilities, backfill, level the road and reinstate asphalt

Duration: Possible four days over two separate weekends

Equipment: Excavator with bucket attachment and concrete breaker, hydrovac, compactor, 6-8 wheel trucks

What to expect:

  • Noise and vibration from excavation and compacting

  • Road closure and traffic detour in place

  • Traffic management in place to maintain pedestrian and vehicle access to properties


Erect Temporary Services Bridge steel columns and main truss bridge span - January/February 2021 date TBC

Where: Normandy Rd

Scope: Install steel column sections to each bridge pier, main steel truss bridge span and earthing and bonding

Duration: Approximately two weeks
One week – install steel and earthing and bonding
One week – connect services column to truss

Equipment: 200 tonne mobile crane, excavator, rattle guns, hand tools, welding equipment, trucks delivering materials, elevated work platforms (EWPs)

What to expect:

  • Night works required to install columns, main truss bridge span and earthing and bonding

  • Night deliveries – main bridge span delivery will take place outside our normal working hours to comply with Auckland Council’s oversize delivery permits

  • Night works required for service connections on Normanby Road bridge pier to ensure safe working conditions above OHLE wires

  • Some noise and lights from the crane lifting columns and truss into place

  • Crews welding bridge span to columns using EWPs for height access

  • Traffic management in place

  • Trucks delivery materials to site
