City Rail Link
west.jfif

Maungawhau Station West archive

Maungawhau Station West archive


SURROUNDING STREETS: Fenton Street, Wynyard Road, Haultain Street, Brentwood Avenue, Ngahura Street, Porters Avenue, New North Road, Dominion Road.

This page is an archive for all Maungawhau station notifications.



Various work in rail corridor 21 and 22 August

Where: In the rail corridor - west of the station (zones 4 and 5)

Scope of work:

  • Hoarding removal

  • Excavation and formation work under Dominion Road Bridge

Equipment: Rock breaker, excavator, compactor, hand tools, small crane, trucks, hot mix asphalt

What to expect: The hoardings will be removed to enable sufficient space for the excavation and track formation work. This work is expected to create some noise so mats will be used to mitigate noise nuisance.

Temporary re-route of pedestrian crossing 21 and 22 August

Where: Porters Avenue (zone 5)

Scope of work:

To enable the relocation of the utilities services in the area of the current pedestrian crossing, the crossing will be re-routed further west for the duration of this weekend work.

Equipment: Digger, excavator, hand tools, compactor, roller, hydro-vac.

What to expect: This work will involve excavation to find and relocate the utilities services in this area. We expect there will be some noise disturbance so where possible, noise mats will be used to mitigate disruption.


30 July 2021

Huia 2 completion delayed

The ongoing work on the Huia 2 watermain relocation has taken several months. We are now close to completion however the final cutover (when the existing pipe and the new pipe are joined) and commissioning (flushing the pipe of any debris and making ready for the water to flow) work will require some weekend and over-night work.

Please note, this work which included night and weekend periods has now been unexpectedly delayed until mid August. We will keep you updated once a new date is confirmed. We apologise for any inconvenience this delay may cause. This work was to take place at the intersection of Wynyard Road / Fenton Street, and outside Station R apartments, 11 Fenton Street.


30 July 2021

Utilities work, Porters Avenue

Due to the complexity of the utilities services in a compact area, we need to relocate some services in Porters Avenue, close to the rail corridor.

We will first be cutting the asphalt with a concrete saw then with the use of an excavator, be digging a trench.

A hydro-vac with assist with further location of services. Once the trench has been dug, a trench shield will be installed so that the required work can be undertaken.

Plate compactors will assist with the reinstatement using material supplied by 6-wheeler trucks. This work will take place across the driveway between Kennards Self Storage and the rail corridor, and will not be accessible during this period of work.

The work will take place between 7am and 7pm, Saturday 14 August and 8am to 7pm on Sunday 15 August and expect there to be noise and vibration disturbance. We will mitigate with noise mats where possible.


Weekend work along the rail corridor, 10th - 11th July

To work on the existing rail tracks, Link Alliance utilises KiwiRail’s Block of Lines (BOL) which are short periods throughout the year when trains are not running on the rail network. The next BOL is Saturday 10th – Sunday 11th July.

Removal and installation of the Overhead Line Equipment (OHLE) masts and equipment

Saturday 10th and Sunday 11th July, 8am - 6pm

Where: Dominion Road overpass however the high-rail vehicle (HRV) will be accessing the rail corridor at Morningside

Equipment: High-rail vehicle, truck with hiab and trailer

What to expect: Likely impacts from noise and lights. Noise from plant and banging of steelwork with hammers. The high-rail vehicle is required to sound the horn before each movement. Vehicle and work lights will be used during reduced daylight in accordance with KiwiRail HRV plant operation rules and procedures.

Adjusting / removing rail hoardings Sunday 11 July from 2pm for 3-4 hours

Where: Dominion Road overpass

Scope of work: To allow access for other crews to complete their work, the hoardings need to be removed or relocated.

Equipment: Excavator and hand tools

What to expect: We expect there to be minimum noise and disruption. Vehicle movements.

Installing lighting and CCTV cameras Saturday 10th and Sunday 11th July, 8am - 6pm

Where: Temporary Services Bridge, Normanby Road

Scope of work: Continuation of work on the bridge in preparation for the opening of pedestrian access

Equipment: Hand tools

What to expect: We expect there will be minimum noise or disruption,

Various work at the rail level crossing Saturday 10th and Sunday 11th July, 8am - 6pm

Normanby Road bridge construction site

Scope of work:

• Removal of the flashing lights and bells from the crossing

• Installation of hoarding at Normanby Road level crossing

• Closing current pedestrian crossing and relocating to the Temporary Services Bridge

Equipment: Crane, excavator, hiab truck

What to expect: We expect there to be noise, vibration, truck movements and a change of the pedestrian route. To reduce the impact of our work we will be installing noise mats and cones to support way finding.

Various works at the rail corridor Saturday 10th and Sunday 11th July, 8am - 6pm

Where: Rail corridor between Normanby Road and Mt Eden Road

Scope of work:

• Installation and replacement of hoardings

• Excavation and installation of utilities ducts

Equipment: Excavators, dump trucks

What to expect: We expect there to be noise, vibration, truck movements. We will be installing noise mats to reduce noise impacts.


16 June 2021

Urgent work in the rail corridor

We need to undertake some urgent work in the rail corridor tonight in the areas indicated by the red dots below.

For each of these locations, a rail deflection monitoring target was installed during a recent block of line, when we were able to access the rail corridor. The targets are similar to those shown below.

As a train passes over the track at these points, a video recording is made to observe the movement of the targets under train loading.

This recording is analysed to estimate the deflection of the sleeper and the ground beneath, which then enables us to check some of the key track-form design parameters. We need to record a freight train, as these are heavier than a passenger train and for our purposes, the heavier the train loading the better. Freight trains run twice per day, one at around 2300 hrs and another around 0400 hrs. Given the times that these trains come through, we need to direct a light downwards onto the targets, at track level, when we take the video. We do not expect any noise or disruption from this work.


20 May 2021

Queen's Birthday weekend - Block of Line work

As part of the ongoing work to build the additional CRL line, we will be working on a variety of activities in the rail corridor over Queen's Birthday weekend during Block of Line, when the trains are not running.

NIGHTWORK Hoarding de-install 4 June 11pm - 5am

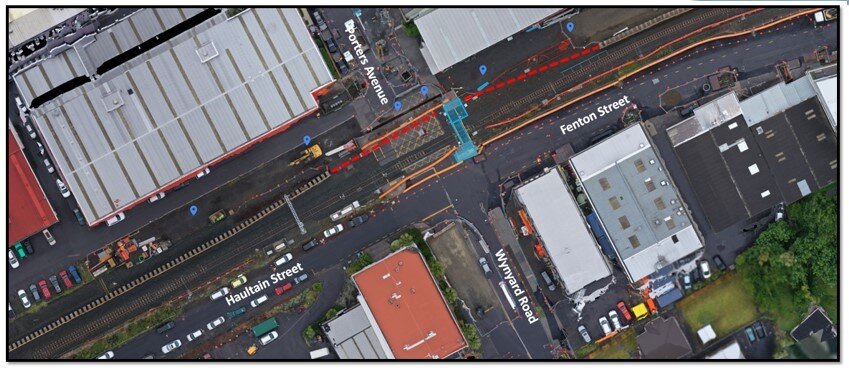

Where: In the rail corridor - west of the station (zone 5 - image below)

Scope of work: Removal of hoarding to make way for the weekend work

Equipment: Hand tools, crane

What to expect: This work will involve removing the existing hoarding to make way for the works that are happening in the rail corridor over the Queen's Birthday weekend. It is not expected that this work will create any noise disruption however we will mitigate where possible.

Various works in rail corridor

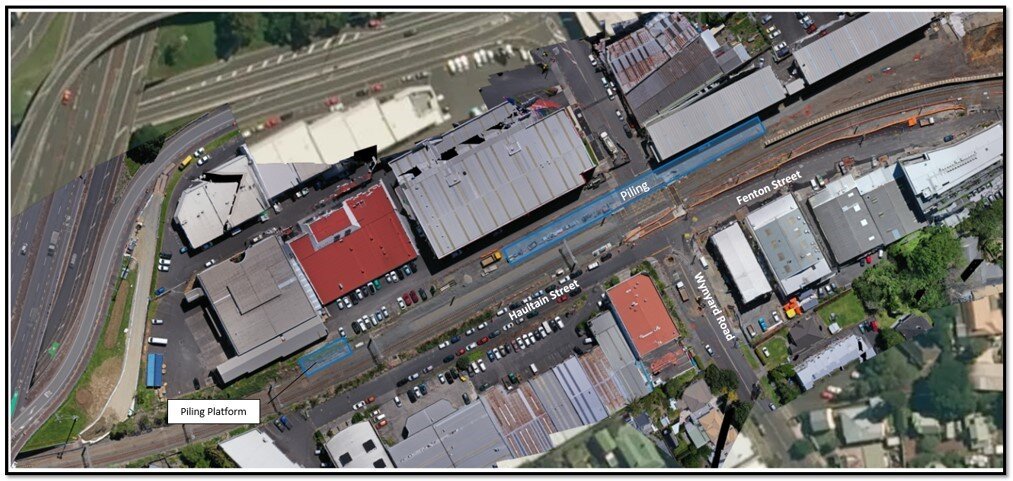

Where: In the rail corridor - west of the station (zone 5 - image above)

Scope of work:

• Piling foundations for two overhead electrification masts

• Track removal, excavation and formation under the Dominion Road over-bridge

• Installation of under-track utilities

• Removal of ballast and rock breaking through basalt

• Truck movements

Equipment: Digger, excavator, hand tools, rock breaker, compactor, piling rig and support crane, concrete trucks, roller.

What to expect: This work will involve removing the existing track and sleepers. There will also be ongoing excavation on site, installation of under-track services and formation of new tracks. There will be ongoing movements from trucks carrying aggregate.

Where possible, noise mats will be used to mitigate noise disruption.

Trail blasting

Where: In the rail corridor near Porters Avenue

Scope of work: We will be drilling approximately three to five small holes in which we will place small explosive charges for the purpose of monitoring the vibration during detonation. The purpose of this trial is to enable us to better understand how the rock will behave and the vibrational effects on the surrounding area.

If blasting is found to be viable, it may be a preferred option for next years trench work and will avoid long periods of rock breaking to remove the basalt.

Equipment: Hand tools

What to expect: Due to this work involving only small charges, it is unlikely that there will be any noticeable effects and if so, they will be fleeting. Special blasting mats will be placed over the charge site to minimise rising dust and prevent any spread of rock. Sensitive vibration monitors will also be placed in various locations around the site, so we can accurately assess and monitor the impacts of each individual blast on the surrounding area.


Works Notification Ngahura Street Nightworks

We will be carrying out remediation works to the north end of Ngahura Street (near the intersection with New North Road) overnight from Tuesday 13th April.

This work will involve laying new asphalt to restore the road surface and is anticipated to be completed on Wednesday 14th April. Indicative location is shown below in blue.

  • Road access will be maintained for residents and businesses on Ngahura Street and managed by a traffic controller.

  • Noise mitigation will be used where possible to minimise any impact.


Large Crane Delivery

On Saturday 24th April, a large 200 tonne crane will be delivered through the Ngahura Street site entrance and installed on site in the western area of the site. 6-7 flat deck trucks will be used to bring the different crane parts to site, and a 100 tonne mobile crane will be used to set this up.

The crane will be used to lift in precast prop beams and deck segments which will eventually make up part of the future underpass structure, where the existing western train line will meet the new western CRL line. This crane will be utilised on site from mid April to August to carry out this work.


Investigation work Saturday 3rd April Rail corridor, eastern side of Dominion Road overpass

Scope of work:

We will be investigating to find utilities ducts and digging a soak hole / drain.

Duration: One day

Equipment: Small excavator and hand tools

What to expect: Low level of noise when removing of the ballast


Change of pedestrian crossing / power switch over / piling from 5 April to mid May Porters Avenue pedestrian crossing

Scope of work:

The pedestrian crossing will be moved approx 2 meters to enable us to relocate the power cable that is currently in the way of the ongoing piling work.

Duration: approximately 5 weeks

5 April: Pedestrian crossing location moved
12 April: Power switched. This work will be completed overnight and will have been notified by Vector
Early May: Commencement of piling for two piles only

Equipment: Small excavator, hand tools, crane, piling rig

What to expect:

  • The pedestrian crossing change will create minimum disruption and will be supported by traffic management

  • Power switchover occurring during night time hours and should only take approx one hour

  • Noise and vibration from the piling rig

  • Truck movements and related noise


Utilities Duct Installation Week commencing 15 March

Scope: Excavate a trench, locate the utilities and install ducts, backfill and asphalt

Time: Expected completion now 4 April

Equipment: Small excavators, concrete cutter, hydro-vac, compactor, 6-8 wheel truck

What to expect:

  • Noise and vibration from excavation, concrete breaking and compacting

  • Traffic management in place to maintain vehicle access to private property

  • The road will be narrowed to accommodate the work


Street Parking Removal along Haultain Street March 2021

Scope: Removal of on-street parking to enable a variety of works for the CRL project such as construction of the Porters Avenue Bridge and North Auckland Line (NAL) railway line

  • Mid Feb 2021 - Auckland Transport street parking removed and long term traffic management plan put in place. Duration: Long-term parking removal will be active for approximately two years


Huia 2 Watermain Installation- End of week commencing 22 February

Where: Fenton Street

Scope of work: Excavate a 4 meter wide trench along Fenton Street in stages starting from the eastern end, install 1300mm diameter pipe, backfill each area, compact and asphalt

Duration: Approximately three months to complete

Equipment: Two large excavators, concrete breaker, hydrovac, compactor, 6-8 wheel trucks, concrete breaker, trench shields, plate compactors

What to expect

  • Noise and vibration from excavation, concrete breaking and compacting

  • Traffic management in place to maintain vehicle access to private property

  • To enable continued traffic movement, the footpath on the corner of Wynyard Road will be incorporated into the road and pedestrians will be diverted onto the eastern side of the road.

  • From Monday 8 March, we will be progressing to the front of Station R apartments which will restrict access to the underground car park. We will be working from 8am to 6pm.

  • Although we are trenching in this area, we can provide access by laying a steel plate over the trench. We will also provide five standby parks which we request you may consider for short term stays. This area is not available for overnight parking.

  • The trench will continue westwards and will be in front of Ace Heavy Haulage driveway from approximately 11 March, covering the trench with a plate is available to enable access.

Piling in rail corridor Week commencing 22 February

Where: Between Porters Ave and Dominion Rd

Scope of work: Drilling 10 piles within the southern side of the rail corridor. This is a continuation of the ongoing piling work.

Duration: Approximately one and half weeks to complete dependent on ground conditions

Equipment: Crane, piling rig

What to expect:

  • Noise and vibration from piling rig

  • Truck movement and related noise

Construction of piling platform for bridge piles - Week commencing 8th March

 Where: Ngahura Street

 Scope of work: We will be building a platform from which to service the piling rig. Once complete the piling rig will drill three holes for the bridge piles.

 Duration: Approximately one and half weeks to complete dependent on ground conditions

 Equipment: Crane, piling rig, vibro roller

 What to expect:

  • Noise and vibration from piling rig

  • Truck movement and related noise

Street Parking Removal along Haultain Street - March 2021

Where: Haultain Street

Scope of work: Removal of on-street parking to enable a variety of works for the CRL project such as construction of the Porters Avenue Bridge and North Auckland Line (NAL) railway line

  • Mid Feb 2021 - Auckland Transport street parking removed and long term traffic management plan in place

Duration: Long-term parking removal will be active for approximately two years

^ back to top


Road closure on Ngahura Street extended

The road closure will be extended for an additional day, 19 February, to continue the road restoration work (weather dependent).
Access will be maintained for residents and businesses.

Road restoration  7am to 7pm,  Friday 19 February Ngahura Street (Northern end)

Scope: The work will include laying new asphalt to restore the road

Equipment: Small trucks, hot mix, plate compactor

This work is being carried out to restore the road surface at the northern end of Ngahura Street. Road access will be maintained for residents and businesses.  Noise mitigation will be used where possible, to minimise the impact.


Huia 2 Watermain Installation

End of week commencing 22 February Fenton Street

Scope: Excavate a 4 meter wide trench along Fenton Street in stages starting from the eastern end, install 1300mm diameter pipe, backfill each area, compact and asphalt

Time: Approximately three months to complete

Equipment: Two large excavators, concrete breaker, hydrovac, compactor, 6-8 wheel trucks, concrete breaker, trench shields, plate compactors

What to expect:

  • Noise and vibration from excavation, concrete breaking and compacting

  • Traffic management in place to maintain vehicle access to private property

To enable continued traffic movement, the footpath on the corner of Wynyard Road will be incorporated into the road and pedestrians will be diverted onto the eastern side of the road.


Piling in rail corridor

Week commencing 22 February Between Porters Ave and Dominion Rd

Scope: Drilling 10 piles within the southern side of the rail corridor. This is a continuation of the ongoing piling work.

Time: Approximately one and half weeks to complete dependent on ground conditions

Equipment: Crane, piling rig

What to expect:

  • Noise and vibration from piling rig

  • Truck movement and related noise


Street Parking Removal along Haultain Street - March 2021

Scope: Removal of on-street parking to enable a variety of works for the CRL project such as construction of the Porters Avenue Bridge and North Auckland Line (NAL) railway line

Mid Feb 2021 - Auckland Transport street parking removed and long term traffic management plan in place

Duration: Long-term parking removal will be active for approximately two years.

As with all our construction activity, we will be monitoring for noise, dust and vibration and have monitoring equipment in place that will alert us if we are going over set limits. We will also be:

  • Using attended monitoring during construction to measure noise and vibration levels so we can make adjustments to our construction methods, if necessary

  • Receiving deliveries within normal working hours (where possible)

  • Scheduling concrete deliveries within normal working hours (where possible)

  • Keeping you informed and giving plenty of advance notice about any works that need to take place outside of normal working hours

We’ll be working between 7am and 10pm Monday to Friday and 7am – 7pm on Saturday. We will keep you informed regarding any work that falls outside of these hours, further details and any changes.


Installation of Ducts Commencing 15 February Along the footpath in Haultain Street

The footpath will be excavated to enable installation of ducting for utility services and the road will be reduced to a single lane with traffic controllers assisting.

Time: Four weeks

Equipment: Small digger and plate compactor

What to expect:

  • Temporary removal of on-street parking

  • Access to private property will be maintained

  • Minimal noise and vibration

Street Parking Removal along Haultain Street March 2021

Removal of on-street parking to enable a variety of works for the CRL project such as construction of the Porters Avenue Bridge and North Auckland Line (NAL) railway line

What to expect:

  • Mid Feb 2021 - Auckland Transport street parking removed and long term traffic management plan in place

Duration: Long-term parking removal will be active for approximately two years


Road closure

Porters Avenue is closing for two weekends in February however we will maintain access to businesses and private properties within the road closure.

The road will be closed from 7am on Saturday 6 February until 10pm on Sunday 7 February and 7am Saturday 13 February to 10pm on Sunday 14 February, however our working hours will be 7am to 7pm each day.

We will be excavating a trench within Porters Ave to install a water valve as part of the utilities relocation work related to the Porters Ave bridge construction.

You may experience some noise and vibration however we will surround the site with noise reducing matts to help minimise any noise disruption.

Equipment:  A small excavator, a hydrovac truck, concrete saw and rock breaker will be used to create a trench in the road, enabling the utilities team to gain access to and work on the below ground services.

Scope of work:

A road closure will be in place on Porters Avenue over two weekends

  • Traffic Controllers will be on hand to maintain and assist with access to businesses and private properties within the road closure.

  • Some noise may be experienced from the concrete cutter and hydrovac truck, however sound reducing matts will surround the site to help minimise any noise disruption.

^ back to top


Piling for the sub-structure foundation of Porter’s Avenue Bridge – Porters Ave footprint. Ongoing

Where: Within Porters Avenue construction site (adjacent to 3 Porters Avenue)

Scope of work: Drill ten piles, install reinforced steel piling cages and pour concrete

Duration: Approximately to end of January

Equipment: Piling rig, mobile support crane, excavator, concrete trucks, 6-8 wheeler trucks

What to expect:

  • Noise and vibration from excavation, drilling piles and concrete pour

  • Trucks removing spoil and delivering materials

  • Long term traffic management plan in place

  • Pedestrian and vehicle access maintained to private property


Street Parking Removal along Haultain Street- March 2021

Where: Haultain Street

Scope of work: Removal of on-street parking to enable a variety of works for the CRL project such as construction of the Porters Avenue Bridge and North Auckland Line (NAL) railway line

  • Mid Feb 2021 - Auckland Transport street parking removed and long term traffic management plan in place

Duration: Long-term parking removal will be active for approximately two years


Piling for North  Auckland Line (NAL) Retaining Wall- Ongoing

Where: Within the rail corridor, west and east of Porters Avenue (shown in blue in image below)

Scope of work: Drill approximately 65 piles that form part of the retaining wall for the North Auckland Line railway corridor

Duration: Works ongoing until mid-2021

Equipment: Two large piling rigs, a mobile support crane, excavator and trucks

What to expect:

  • Noise and vibration from the drilling rig and the mobile crane lifting metal cages into place

  • Trucks delivering materials and concrete several times a day and removing spoil from the work area

^ back to top


Retaining Wall Piling - January 2021

Where: Within the rail corridor, between Porters Avenue and Dominion Road Overpass (shown in blue in image below) and along1A Porters Ave driveway

Scope of work: Installation of gravity walls and contiguous piles to retain the trench walls

Duration: Approximately two months

Equipment: Piling rig, trucks

What to expect:

  • Noise and vibration from excavation and compacting materials

  • Trucks removing spoil and delivering materials


Huia 2 Watermain Installation - 15 January

Where: Fenton Street

Scope of work: Excavate a 4 meter wide trench along Fenton Street in stages starting from the eastern end, install 1300mm diameter pipe, backfill each area, compact and asphalt

Duration: Approximately three months to complete

Equipment: Two large excavators, concrete breaker, hydrovac, compactor, 6-8 wheel trucks

What to expect:

  • Noise and vibration from excavation, concrete breaking and compacting

  • Traffic management in place to maintain vehicle access to private property

  • To enable continued traffic movement, the footpath on the corner of Wynyard Road will be incorporated into the road and pedestrians will be diverted onto the eastern side of the road

^ back to top


Piling for the sub-structure foundation of Porter’s Avenue Bridge – Wynyard Road footprint- commencing 7 December

Where: Wynyard Road construction site (adjacent to 1A Wynyard Rd)

Scope: Drill nine piles, install reinforced steel piling cages and pour concrete

Duration: About one week

Equipment: Piling rig, mobile support crane, excavator, concrete trucks, 6-8 wheeler trucks

Piling rig, mobile support crane, excavator, concrete trucks, 6-8 wheeler trucks

What to expect:

  • Noise and vibration from excavation, drilling piles and concrete pour

  • Trucks removing spoil and delivering materials

  • Long term traffic management plan in place

  • Pedestrian and vehicle access maintained to private property.

^ back to top


Piling for the sub-structure foundation of Porter’s Avenue Bridge – Porters Ave footprint - Week commencing 14 December

Where: Within Porters Avenue construction site (adjacent to 3 Porters Avenue)

Scope: Drill ten piles, install reinforced steel piling cages and pour concrete

Duration: About one week

Equipment: Piling rig, mobile support crane, excavator, concrete trucks, 6-8 wheeler trucks

What to expect:

  • Noise and vibration from excavation, drilling piles and concrete pour

  • Trucks removing spoil and delivering materials

  • Long term traffic management plan in place

  • Pedestrian and vehicle access maintained to private property


Remove Wynyard Road piling platform and Backfill Pile Locations - Week commencing 14 December

Where: Wynyard Road construction site (adjacent to 1A Wynyard Rd)

Scope:

  • Remove piling platform using excavator with bucket attachment

  • Place and compact aggregate material, cover with asphalt

Duration: About one week

Equipment: Excavator with bucket attachment, 6-8 wheel trucks, vibro-roller, compactor

What to expect:

  • Noise and vibration from platform removal and compacting

  • Mild odour from asphalt covering

^ back to top


Street Parking Removal along Haultain Street - Late December 2020 and March 2021

Where: Haultain Street

Scope: Removal of on-street parking to enable a variety of works for the CRL project such as construction of the Porters Avenue Bridge and North Auckland Line (NAL) railway line

Late December 2020 - Parking on Kiwirail designated land removed

March 2021 - Auckland Transport street parking removed and long term traffic management plan in place

Duration: Long-term parking removal will be active for about two years


Piling, Pile Cap and Capping Beam Installation- Saturday 26 December 2020

Where: Within the rail corridor

Scope: Remove hoarding and reinstate when piling works completed

Piling - Drill one pile for station egress and approximately 20 piles for central pier, install reinforced steel cages and pour concrete

Install Pile cap and capping beam - Remove the excess concrete from the pile, install formwork and steel reinforcing, pour concrete slab

Duration: About six weeks

Equipment: Remove & reinstate hoarding - Hi-ab truck, telehandler, generator for powered tools, hand tools – tension control bolt/hydraulic wrench or manual torque wrench

Piling, Pile Cap & Capping Beam - Excavator mounted pile driver, excavator, hand breaker, small digger, concrete truck, truck to remove spoil, hand tools.

What to expect:

  • Hi-ab truck and telehandler lifting concrete blocks, frames and panels

  • Some noise from timber panels and diagonal bracing being detached

  • Noise and vibration from concrete breaking and hand tools when installing formwork and steel reinforcing

  • Trucks removing spoil from the work area and delivering materials and concrete.


Move Level Crossing - Monday 4 January 2021

Where: Porter Avenue level crossing (shown in blue)

Scope: Excavation, reinstate crossing and relocate crossing gate to accommodate new retaining wall

Duration: One week

Equipment: Small excavator, 6-wheel trucks, concrete truck

What to expect:

  • Some noise and vibration from excavation and concrete pour

  • Temporary pedestrian diversion in place

  • Traffic Controllers on hand to assist

Piling for North Auckland Line (NAL) Retaining Wall -January 2021

Where: Within the rail corridor, west and east of Porters Avenue (shown in blue in image)
Scope:
Drill approximately 65 piles that form part of the retaining wall for the North Auckland Line railway corridor

Duration: Works ongoing until mid-2021

Equipment: Two large piling rigs, a mobile support crane, excavator and trucks

What to expect:

  • Noise and vibration from the drilling rig and the mobile crane lifting metal cages into place

  • Trucks delivering materials and concrete several times a day and removing spoil from the work area

^ back to top


Construct Piling Platform (to facilitate drilling piles for the retaining wall for the North Auckland Railway Line) -January 2021

Where: Within the rail corridor, between Porters Avenue and Dominion Road Overpass (shown in blue)

Scope: Excavate to approximately 2 metres deep, backfill with aggregate material and compact to ground level

Duration: About two weeks

Equipment: Excavator with bucket attachment and rock breaker, concrete breaker, vibro-roller, 6-8 wheel trucks

What to expect:

  • Noise and vibration from excavation and compacting materials

  • Trucks removing spoil and delivering materials


Huia 2 Pipe Installation - Late January (date TBC)

Where: Fenton Street

Scope: Excavate along Fenton Street in stages, install 1300mm diameter pipe, backfill each area, compact and asphalt

Duration: About three months to complete

Equipment: Two large excavators, concrete breaker, hydrovac, compactor, 6-8 wheel trucks

What to expect:

  • Noise and vibration from excavation, concrete breaking and compacting

  • Traffic management in place to maintain vehicle access to private property

^ back to top
